The Rule, Factor By Factor
Each term in the figure above.
For solar professionals · free, no signup
A PRC calculator for NSW batteries. Pick the site type and battery size and you'll see the PRCs and the upfront PDRS discount straight away, with the maths shown.
Model the whole site free: bill in, hourly load, every solar and battery size on one grid. No card.
Start free, no cardFor the NSW Peak Demand Reduction Scheme battery incentive (PRCs).
Quoting a business battery? Model it hour by hour against their interval data.
Panels alone earn no PRCs: midday generation does not cut the evening peak. The battery discharging into the 2:30–8:30 pm window does. The panels earn federal STCs instead. Try the STC calculator.

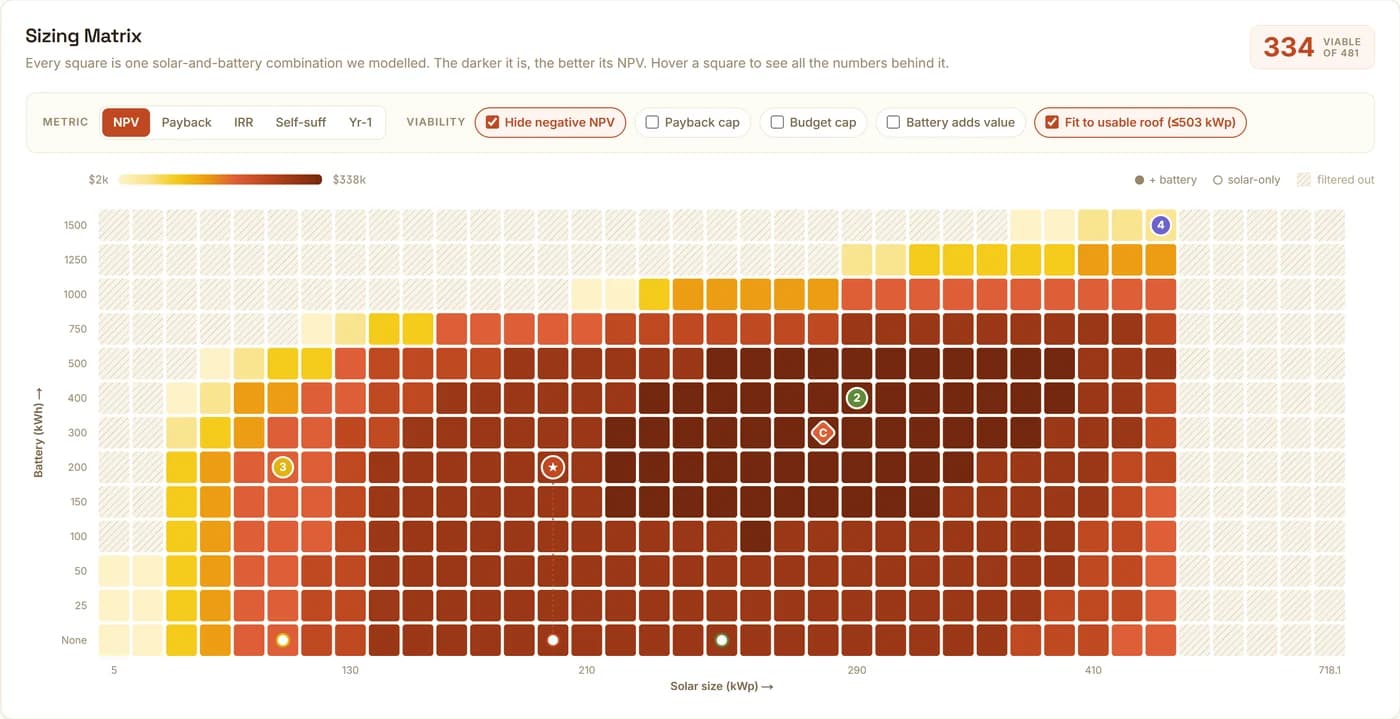

Open Amperage with this PDRS estimate loaded into a project: every size and battery scenario against the real bill, and a branded proposal at the end.
For solar professionals. Free for 30 days, no card. Then $799 a month per company, or free for five projects.A 20 to 30 minute walkthrough of solar and battery sizing for a commercial site. For solar professionals.
We only use this to contact you about Amperage. Privacy
The maths
A battery earns PRCs for the demand it can shift out of the summer evening peak. Usable capacity (90% of nameplate) times the activity coefficient gives the kW shifted. Multiply by the 6 hour peak window, the equipment lifetime and the network loss factor, then by 10 for the certificates, rounded down. The value is paid once, upfront, as an install discount.
Each term in the figure above.
The paperwork. The checklist under the inputs lists it per activity.
The site type and usable size decide the activity.
Questions
The NSW Peak Demand Reduction Scheme, run by IPART as part of the Energy Security Safeguard. It issues Peak Reduction Certificates (PRCs) for cutting demand in the summer evening peak. Batteries earn PRCs under the BESS1 to BESS5 activities in the scheme rule.
A PRC is the certificate the PDRS creates for demand a battery shifts out of the summer evening peak. One PRC is 0.1 kW of peak demand shifting capacity over the equipment lifetime. An Accredited Certificate Provider creates the PRCs and passes their value back as an upfront discount on the battery.
Pick the site type, enter the nameplate battery capacity in kWh and the inverter output in kW, then add any new solar for a business or C&I battery. The calculator shows the PRC count and the upfront discount, with each step of the maths below the figure.
No. There is no NSW scheme called the NESC. People use the name for the Energy Security Safeguard, which runs two schemes: the Energy Savings Scheme (ESCs) and the Peak Demand Reduction Scheme (PRCs). This calculator covers the PDRS battery activities.
The calculator picks it from the site type and battery size. BESS3 is apartment buildings of four or more dwellings, BESS4 small and medium businesses (20 to 200 kWh) and BESS5 commercial and industrial sites (200 kWh to 30 MWh), all for batteries installed from 7 September 2026. BESS2 onboards an existing battery for demand response from 1 July 2026. BESS1 (homes, 2 to 28 kWh) is suspended: no PRCs for home batteries installed after 30 June 2025, except through the Home Energy Saver Discounts Program or at a government owned site.
Usable capacity (90% of nameplate) times the activity coefficient gives the peak demand shifting capacity in kW. Multiply that by the 6 hour peak window (2:30 to 8:30 pm), the equipment lifetime (15 years, or 6 for BESS2) and your network loss factor. One certificate per 0.1 kW, so PRCs = capacity x loss factor x 10, rounded down.
Upfront. The PRCs are deemed over the equipment lifetime and created once, so the value is one amount, paid as an install discount through an Accredited Certificate Provider.
Panels alone do not. Midday generation does not cut the evening peak; the battery discharging into the 2:30 to 8:30 pm window does, and the panels earn federal STCs instead. For BESS4 and BESS5, a battery installed within 90 days of new solar earns 0.10 instead of 0.067, as long as the new solar is at least a quarter of the usable battery capacity. Below a quarter within 90 days, the battery earns nothing. More than 90 days after the solar, or with no new solar, it earns 0.067 with no ratio test. BESS1 (suspended) needs solar at the site.
The inverter output is the AC capacity. It caps the incentive at four hours times the inverter, so an undersized inverter lowers the PRC count. For the business activities the usable capacity must also be no more than six times the inverter output, or the battery is not eligible.
A minimum customer payment ($200 for BESS1, $1,000 for BESS3, $5,000 for BESS4), a battery on IPART's accepted product list, an accredited installer, network and planning consents, and the right install date. BESS4 and BESS5 can be claimed once per site. BESS2 needs a 12 month VPP or aggregator contract and at least 6 years of warranty left.
Only for BESS2, which onboards an existing battery. A new battery under BESS1, BESS3, BESS4 or BESS5 just has to be internet connected and controllable by a demand response aggregator. That is a hardware capability, not a contract.
PRC prices move with the certificate market. The calculator starts from the current market default, which you can change under More options. Confirm the price with your Accredited Certificate Provider before quoting a firm discount.
